KEMBAR78
Agile Introduction - Scrum Framework | PPTX
1

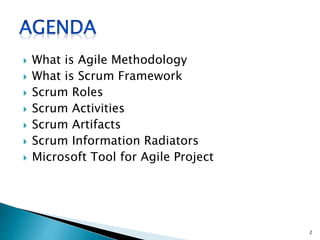

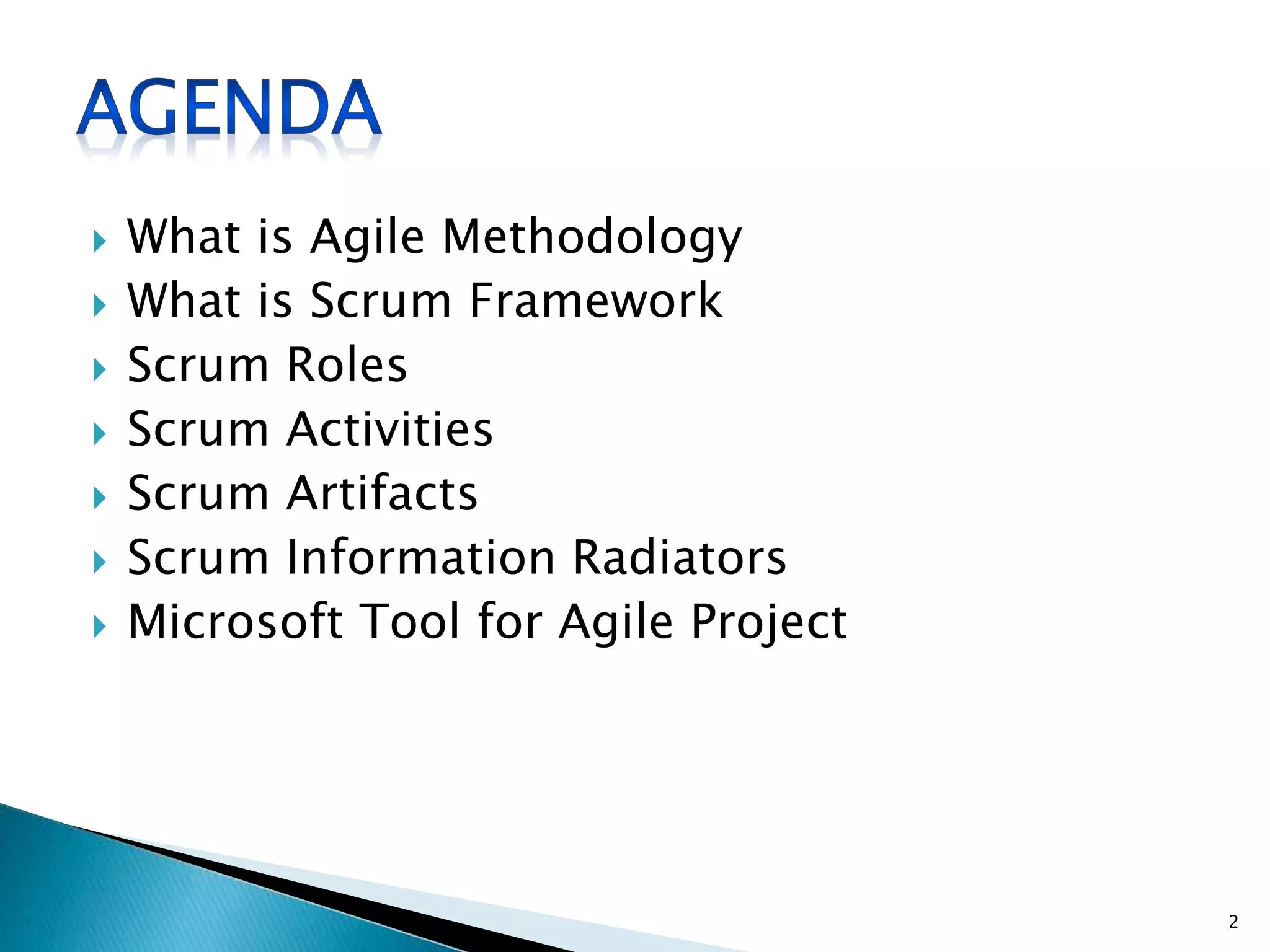

 What is Agile Methodology
 What is Scrum Framework
 Scrum Roles
 Scrum Activities
 Scrum Artifacts
 Scrum Information Radiators
 Microsoft Tool for Agile Project
2

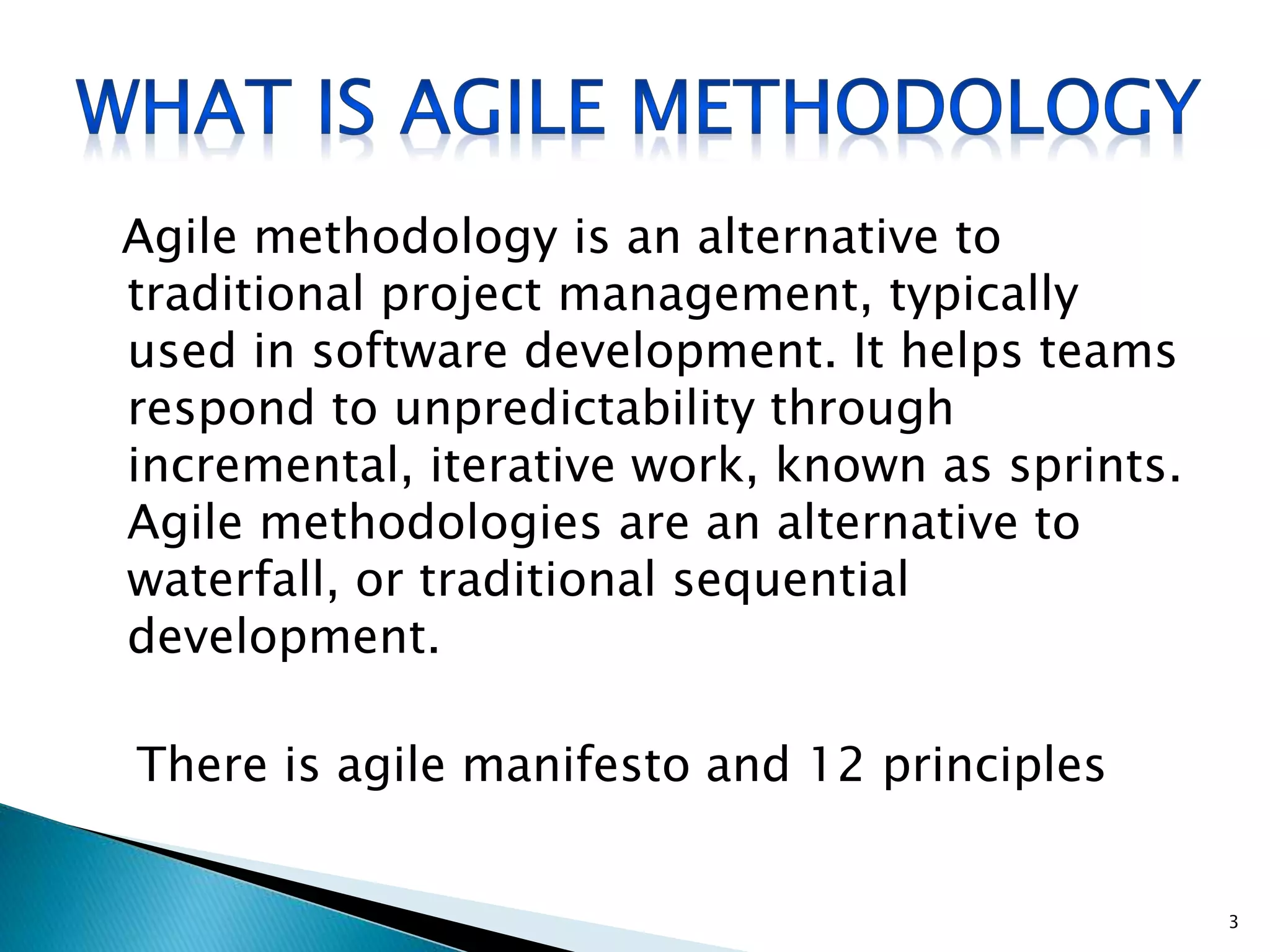

Agile methodology is an alternative to
traditional project management, typically
used in software development. It helps teams
respond to unpredictability through
incremental, iterative work, known as sprints.
Agile methodologies are an alternative to
waterfall, or traditional sequential
development.
There is agile manifesto and 12 principles
3

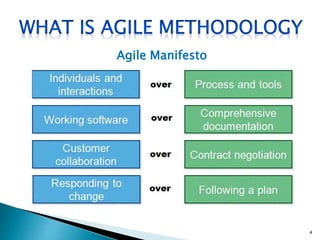

Agile Manifesto
4

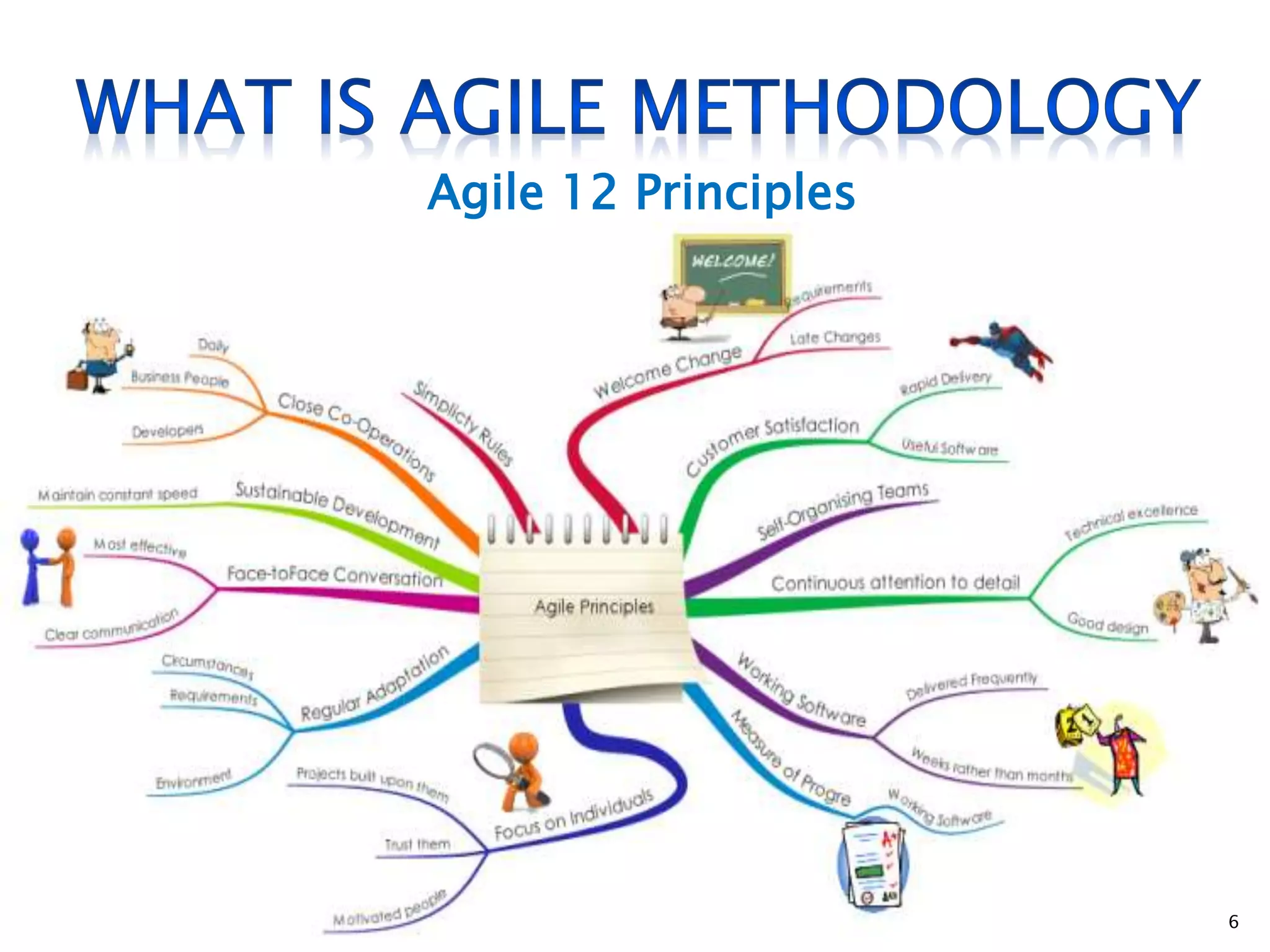

Agile 12 Principles
5
Agile 12 Principles
6

 Scrum is framework which is based on agile
principles, a framework that handle simple,
complicated and complex software development.
 Scrum is based on continuous improvement in
product and process.
 Scrum deliver software frequently (value), it showcase
the hidden problems in systems development.
 In scrum project move forward with series of iteration
that called Sprints.
 Each sprint size is typically two to four weeks long. It
is based on inspect and adaptive cycle.
 Produce product incrementally and iteratively, thus
reduce risk and enhance visibility.
7

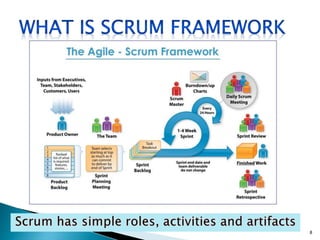

8
 Product Owner
 Scrum Master
 Team

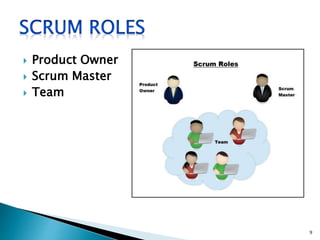

9

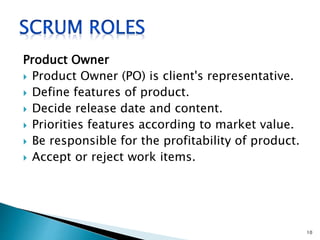

Product Owner
 Product Owner (PO) is client's representative.
 Define features of product.
 Decide release date and content.
 Priorities features according to market value.
 Be responsible for the profitability of product.
 Accept or reject work items.
10

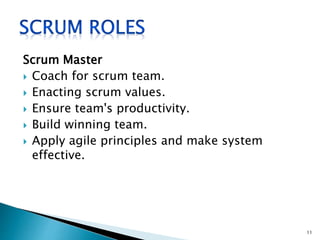

Scrum Master
 Coach for scrum team.
 Enacting scrum values.
 Ensure team's productivity.
 Build winning team.
 Apply agile principles and make system
effective.
11

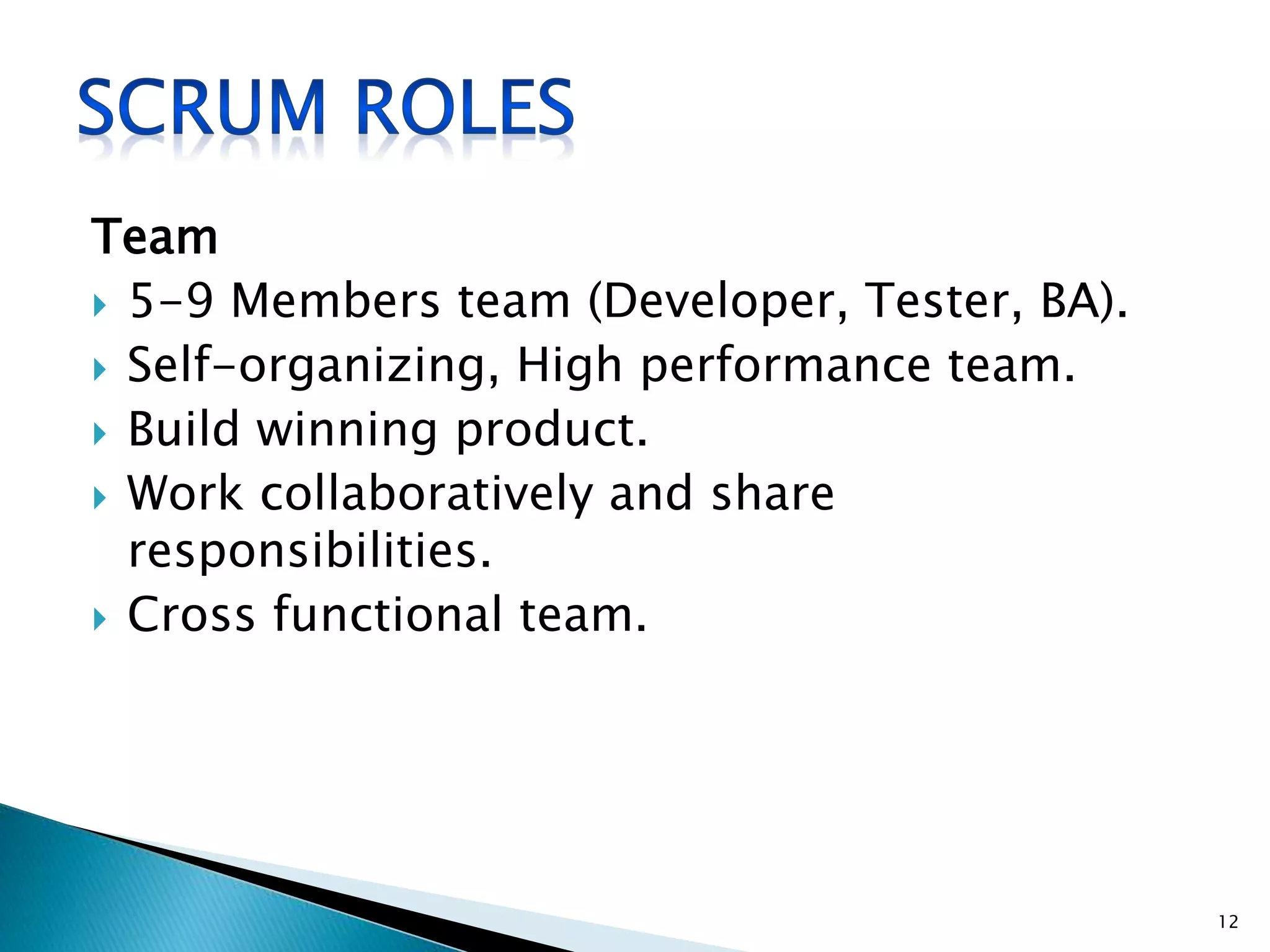

Team
 5-9 Members team (Developer, Tester, BA).
 Self-organizing, High performance team.
 Build winning product.
 Work collaboratively and share
responsibilities.
 Cross functional team.
12

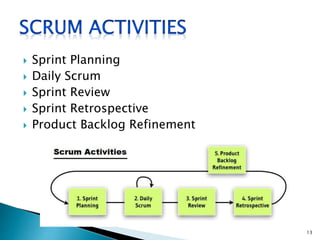

 Sprint Planning
 Daily Scrum
 Sprint Review
 Sprint Retrospective
 Product Backlog Refinement
13

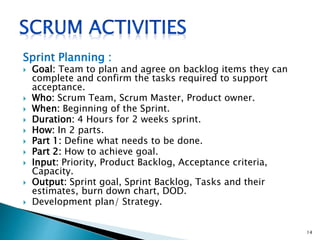

Sprint Planning :
 Goal: Team to plan and agree on backlog items they can
complete and confirm the tasks required to support
acceptance.
 Who: Scrum Team, Scrum Master, Product owner.
 When: Beginning of the Sprint.
 Duration: 4 Hours for 2 weeks sprint.
 How: In 2 parts.
 Part 1: Define what needs to be done.
 Part 2: How to achieve goal.
 Input: Priority, Product Backlog, Acceptance criteria,
Capacity.
 Output: Sprint goal, Sprint Backlog, Tasks and their
estimates, burn down chart, DOD.
 Development plan/ Strategy.
14

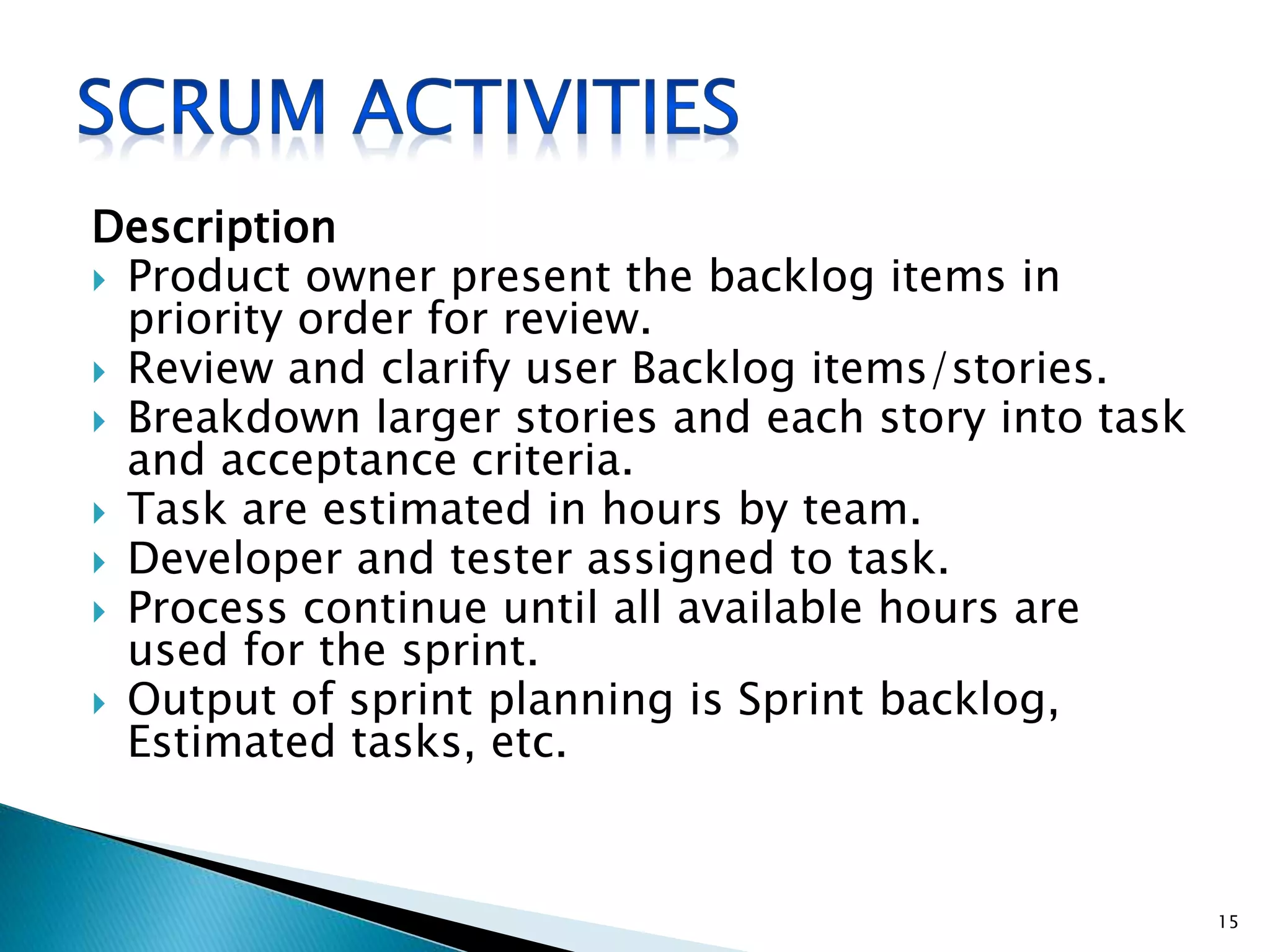

Description
 Product owner present the backlog items in
priority order for review.
 Review and clarify user Backlog items/stories.
 Breakdown larger stories and each story into task
and acceptance criteria.
 Task are estimated in hours by team.
 Developer and tester assigned to task.
 Process continue until all available hours are
used for the sprint.
 Output of sprint planning is Sprint backlog,
Estimated tasks, etc.
15

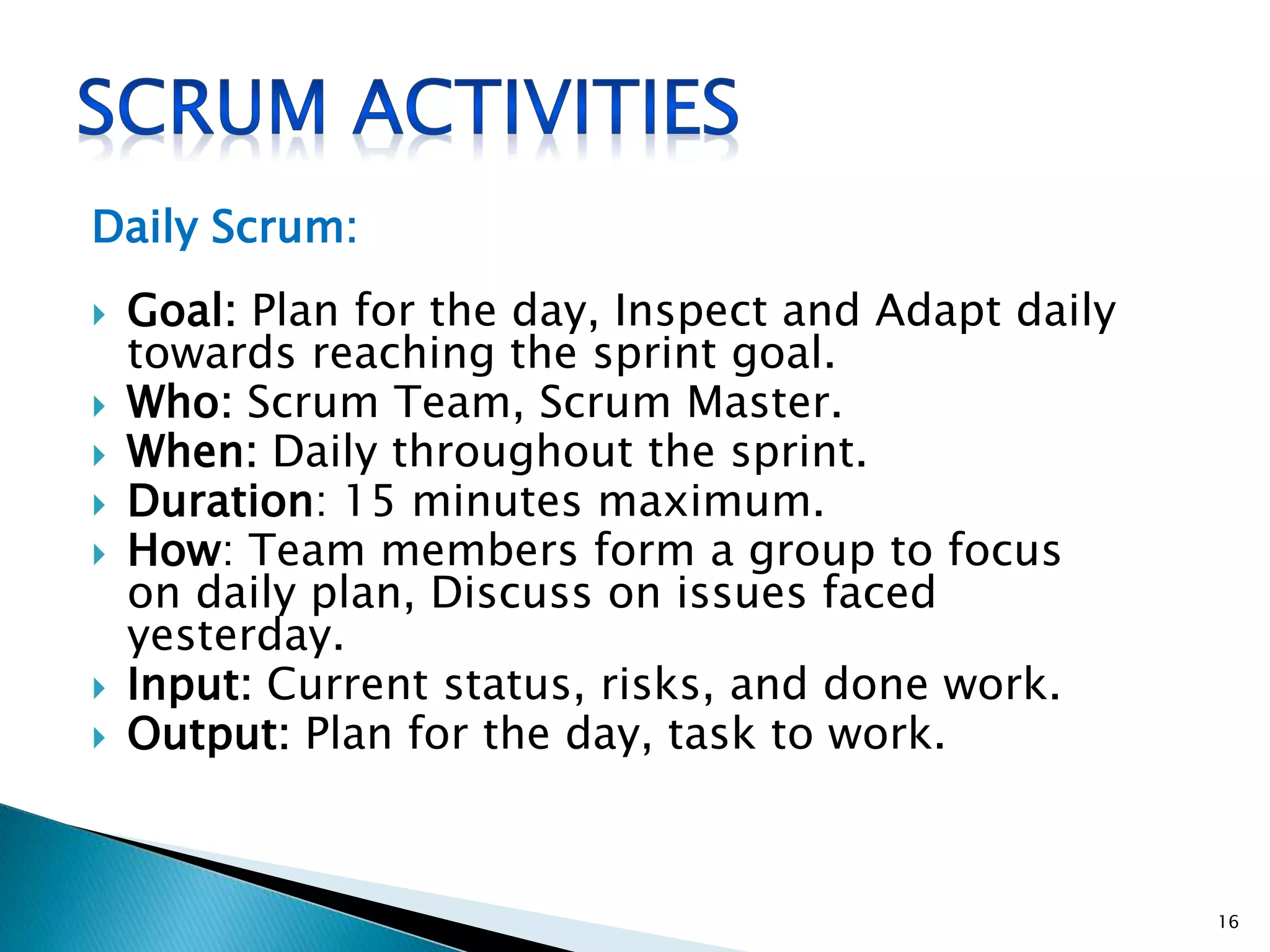

Daily Scrum:
 Goal: Plan for the day, Inspect and Adapt daily
towards reaching the sprint goal.
 Who: Scrum Team, Scrum Master.
 When: Daily throughout the sprint.
 Duration: 15 minutes maximum.
 How: Team members form a group to focus
on daily plan, Discuss on issues faced
yesterday.
 Input: Current status, risks, and done work.
 Output: Plan for the day, task to work.
16
Description:
 Daily development Team standup for 15
minutes in circle and talk only on three
points.
◦ What I did since last daily scrum meeting?
◦ What I am planning to work on today?
◦ Impediments (Issue/blocker) if any?
 Scrum master protect the team and
facilitate for being effective.
 This give an opportunity to team to inspect
and adapt daily on the sprint goal.
17

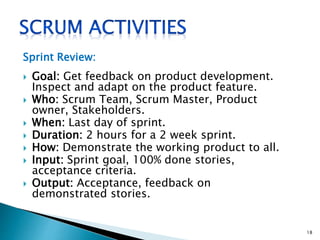

Sprint Review:
 Goal: Get feedback on product development.
Inspect and adapt on the product feature.
 Who: Scrum Team, Scrum Master, Product
owner, Stakeholders.
 When: Last day of sprint.
 Duration: 2 hours for a 2 week sprint.
 How: Demonstrate the working product to all.
 Input: Sprint goal, 100% done stories,
acceptance criteria.
 Output: Acceptance, feedback on
demonstrated stories.
18
Description:
 During this meeting team demonstrate 100%
completed work.
 Scrum master facilitate the environment.
 In case any changes or new request, Product owner
(PO) note and updates the product backlog as
required.
 Product owner is final
decision maker on
acceptance.
19

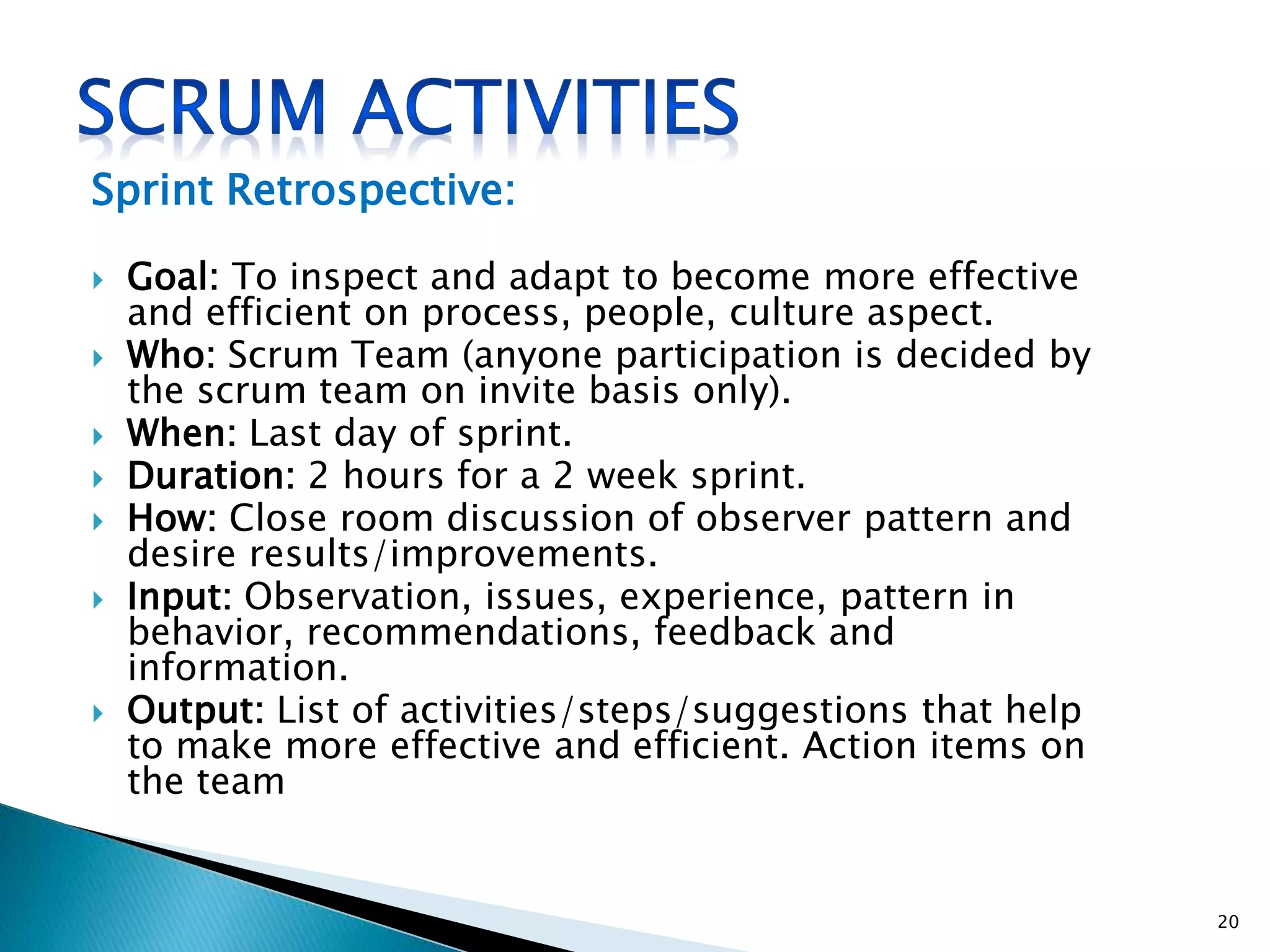

Sprint Retrospective:
 Goal: To inspect and adapt to become more effective
and efficient on process, people, culture aspect.
 Who: Scrum Team (anyone participation is decided by
the scrum team on invite basis only).
 When: Last day of sprint.
 Duration: 2 hours for a 2 week sprint.
 How: Close room discussion of observer pattern and
desire results/improvements.
 Input: Observation, issues, experience, pattern in
behavior, recommendations, feedback and
information.
 Output: List of activities/steps/suggestions that help
to make more effective and efficient. Action items on
the team
20
Description:
 Participation in the discussion to inspect and adapt as scrum team.
 Scrum master play vital role in sprint retrospective, Scrum master
bring in the culture of openness, trust and respect as people discuss
the improvement areas, facilitate and focus on improvement and
changes that pointing fingers at others.
 This is platform to scrum master to help team resolve ineffectiveness
in the systems.
 Inspect and Adapt: Try everything that makes sense, reject things
that didn’t work even after repeated trails. Shape your culture,
process and practice.
21

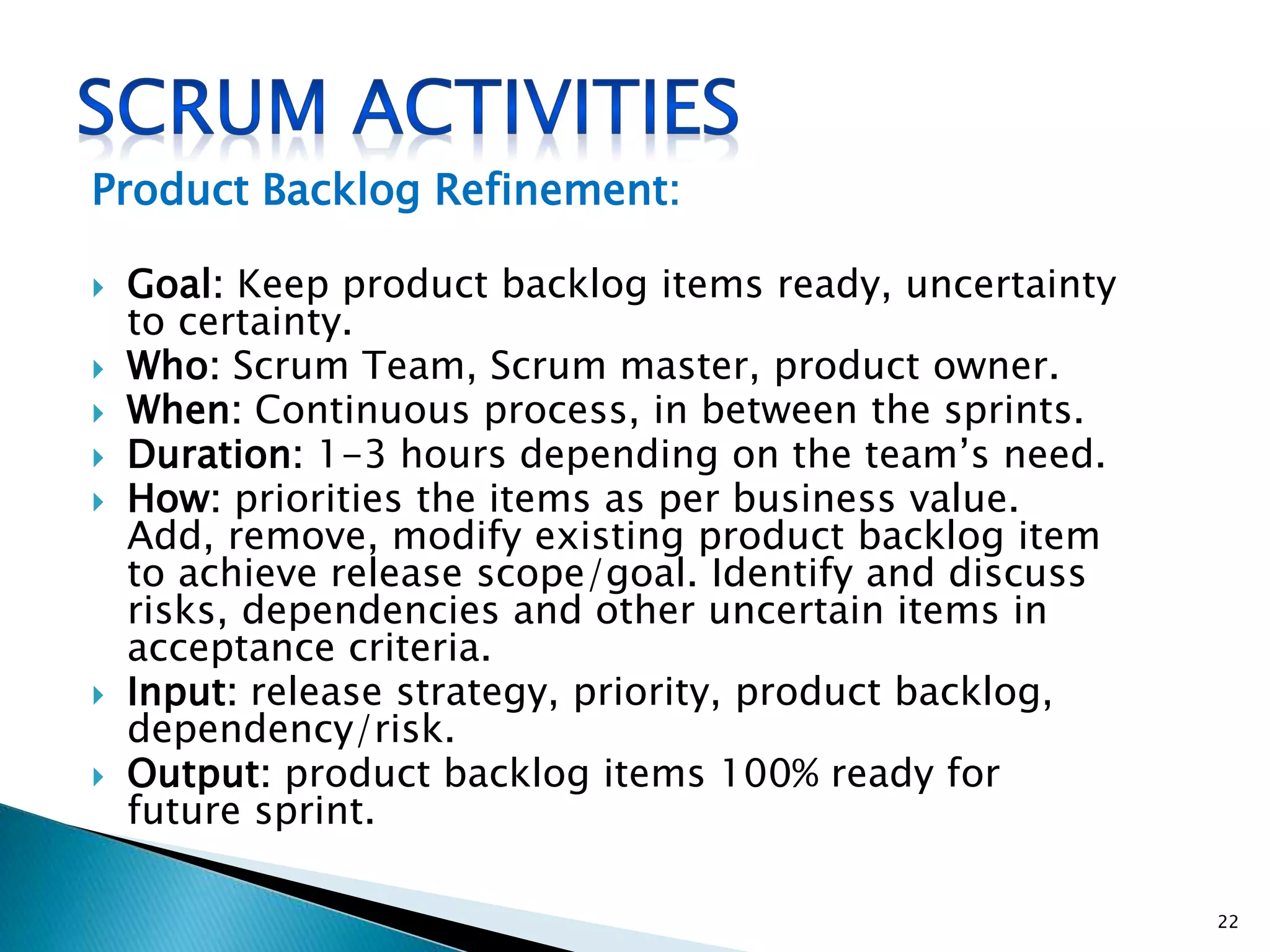

Product Backlog Refinement:
 Goal: Keep product backlog items ready, uncertainty
to certainty.
 Who: Scrum Team, Scrum master, product owner.
 When: Continuous process, in between the sprints.
 Duration: 1-3 hours depending on the team’s need.
 How: priorities the items as per business value.
Add, remove, modify existing product backlog item
to achieve release scope/goal. Identify and discuss
risks, dependencies and other uncertain items in
acceptance criteria.
 Input: release strategy, priority, product backlog,
dependency/risk.
 Output: product backlog items 100% ready for
future sprint.
22

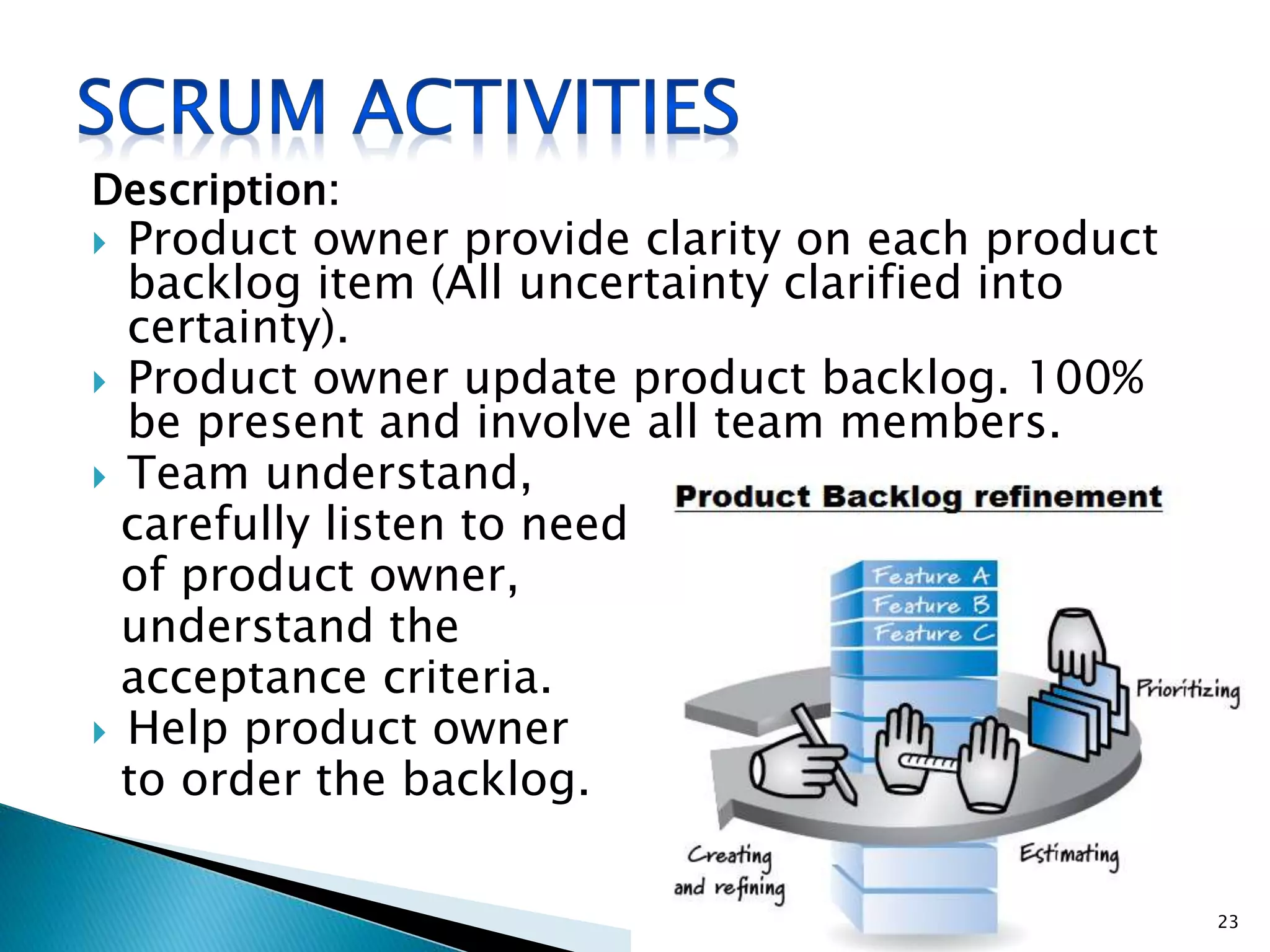

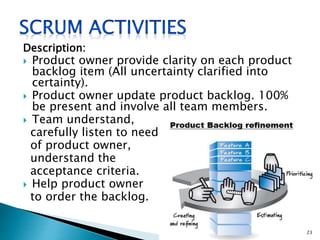

Description:
 Product owner provide clarity on each product
backlog item (All uncertainty clarified into
certainty).
 Product owner update product backlog. 100%
be present and involve all team members.
 Team understand,
carefully listen to need
of product owner,
understand the
acceptance criteria.
 Help product owner
to order the backlog.
23

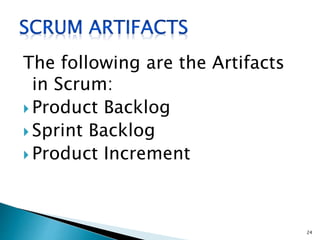

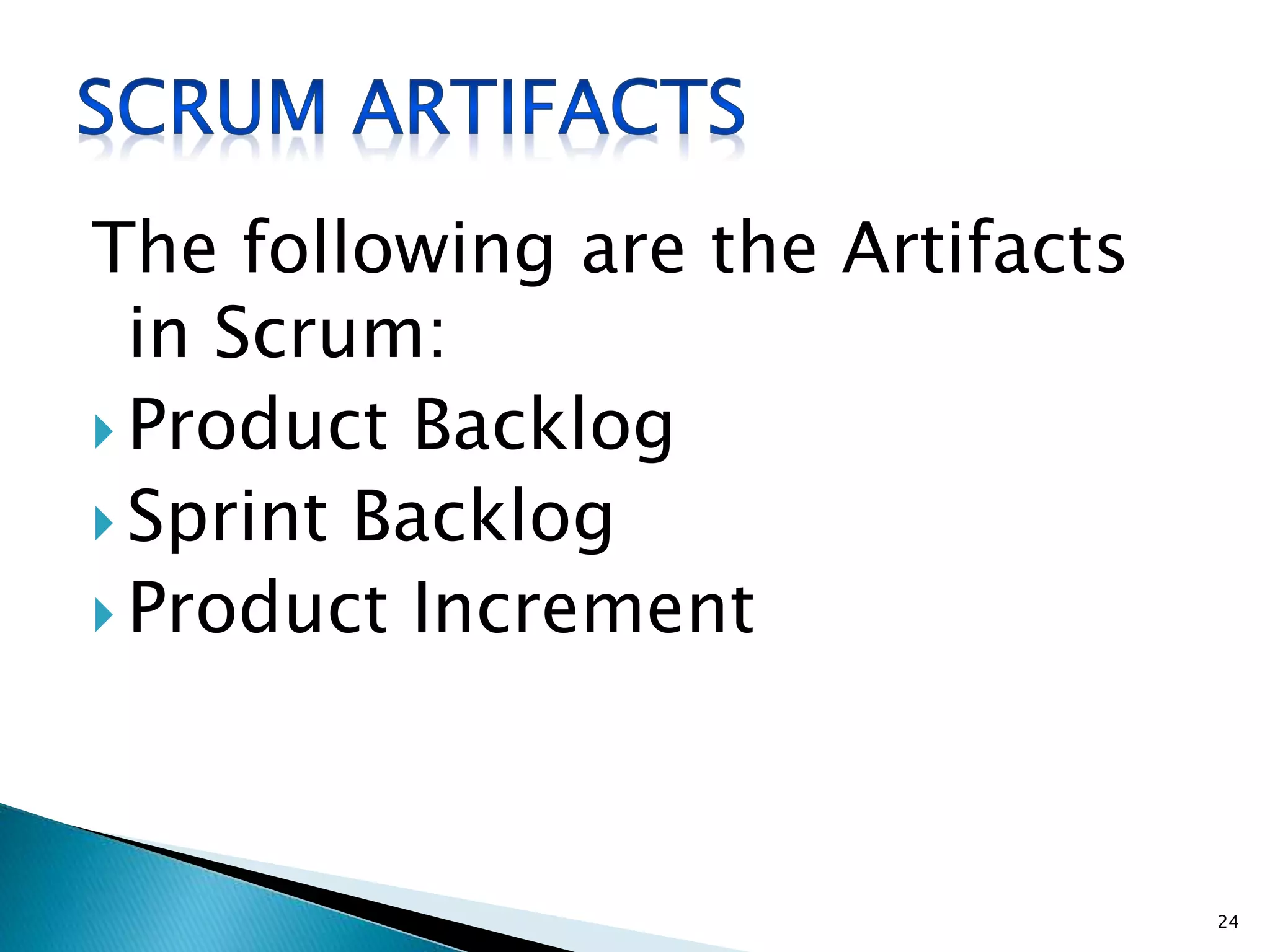

The following are the Artifacts
in Scrum:
 Product Backlog
 Sprint Backlog
 Product Increment
24

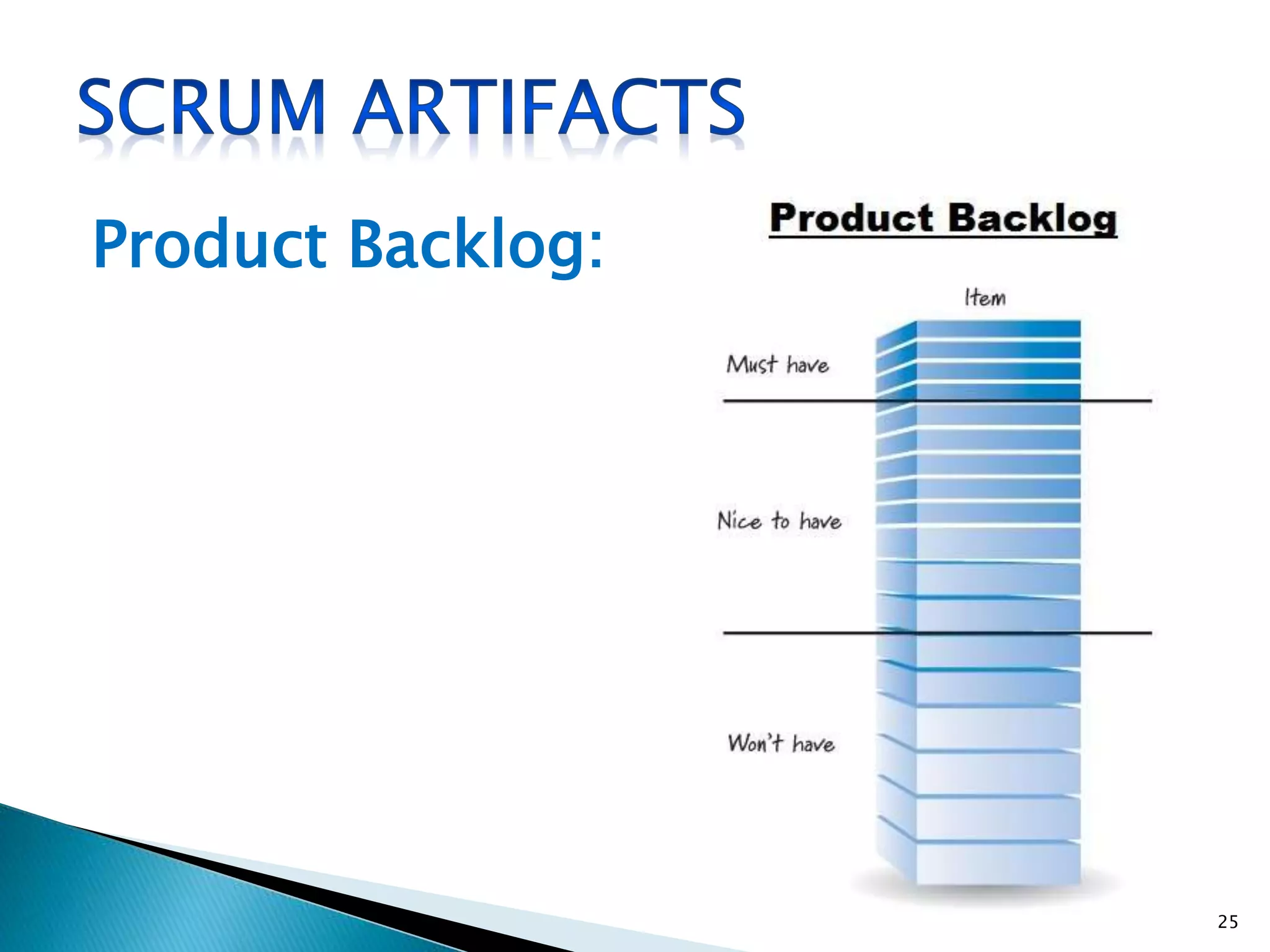

Product Backlog:
25

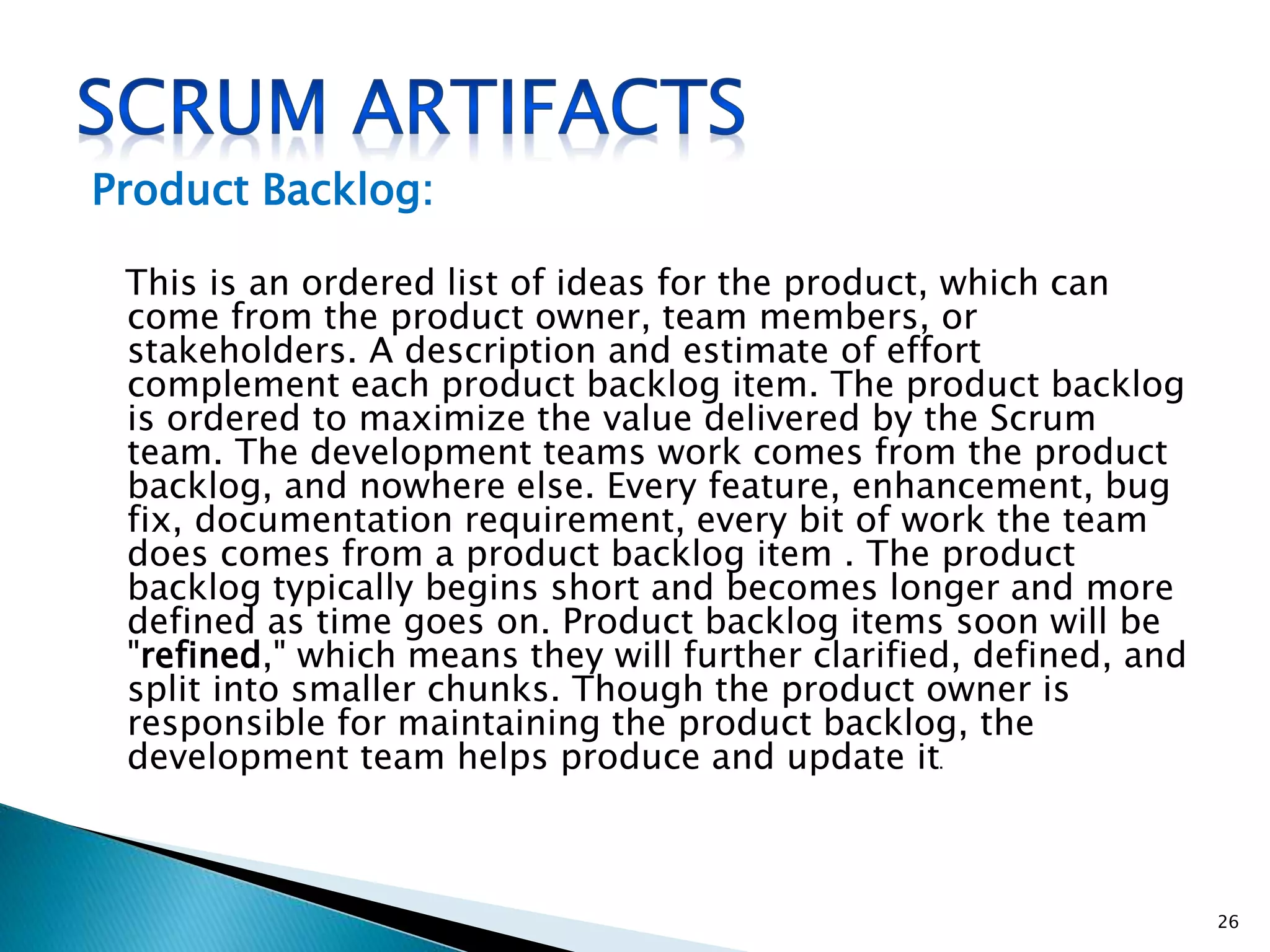

Product Backlog:
This is an ordered list of ideas for the product, which can
come from the product owner, team members, or
stakeholders. A description and estimate of effort
complement each product backlog item. The product backlog
is ordered to maximize the value delivered by the Scrum
team. The development teams work comes from the product
backlog, and nowhere else. Every feature, enhancement, bug
fix, documentation requirement, every bit of work the team
does comes from a product backlog item . The product
backlog typically begins short and becomes longer and more
defined as time goes on. Product backlog items soon will be
"refined," which means they will further clarified, defined, and
split into smaller chunks. Though the product owner is
responsible for maintaining the product backlog, the
development team helps produce and update it.
26

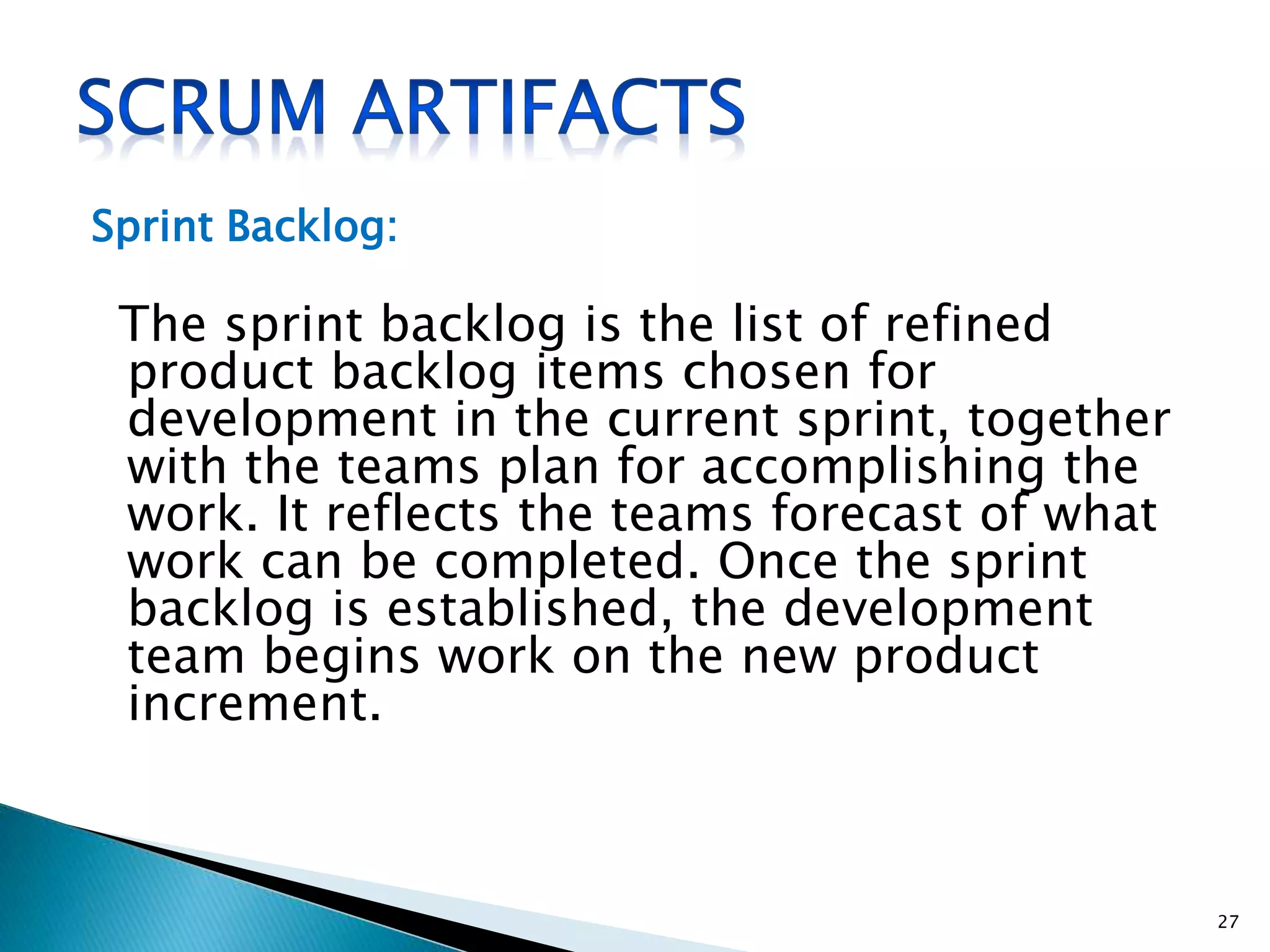

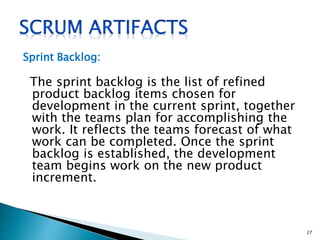

Sprint Backlog:
The sprint backlog is the list of refined
product backlog items chosen for
development in the current sprint, together
with the teams plan for accomplishing the
work. It reflects the teams forecast of what
work can be completed. Once the sprint
backlog is established, the development
team begins work on the new product
increment.
27

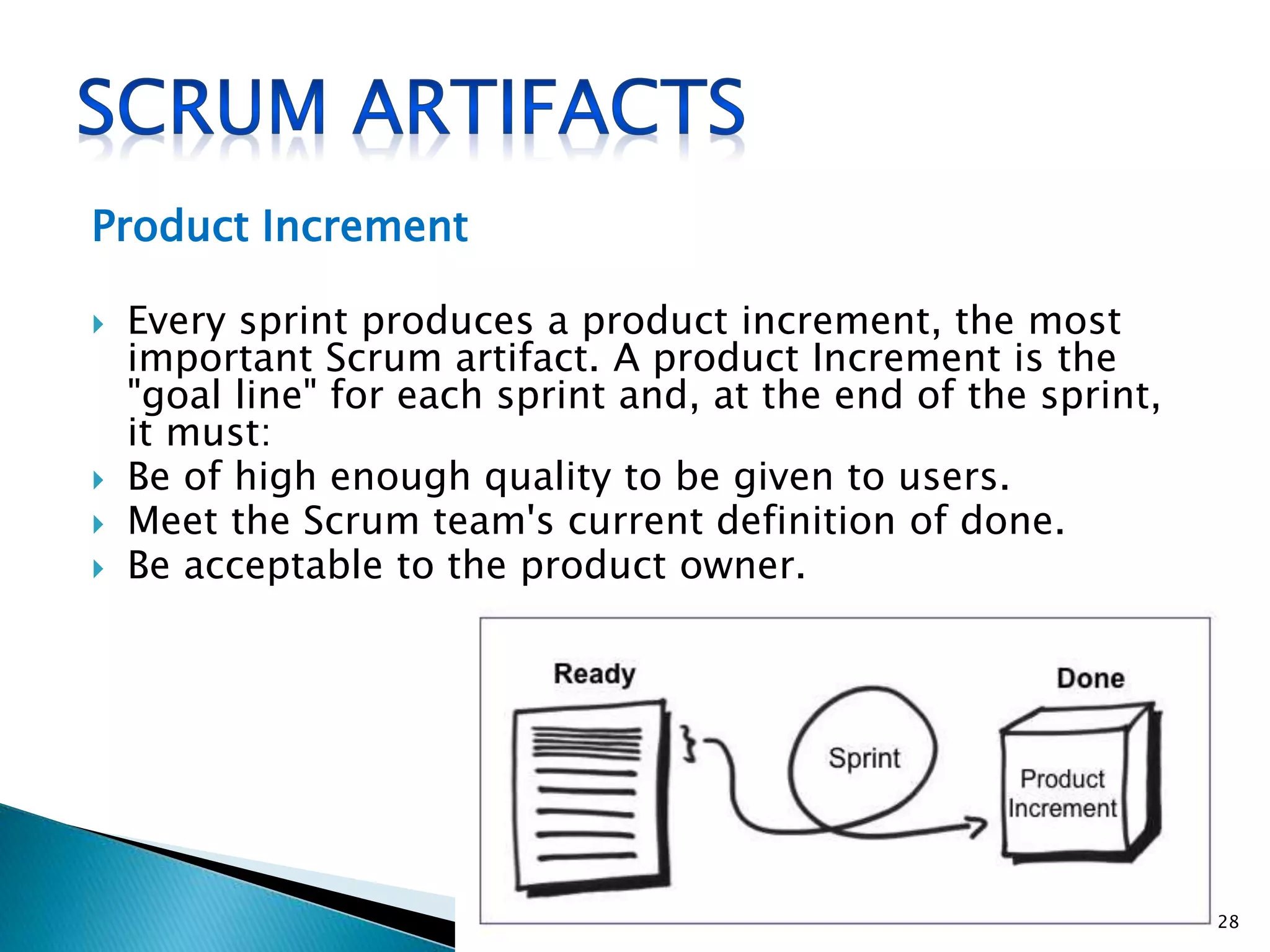

Product Increment
 Every sprint produces a product increment, the most
important Scrum artifact. A product Increment is the
"goal line" for each sprint and, at the end of the sprint,
it must:
 Be of high enough quality to be given to users.
 Meet the Scrum team's current definition of done.
 Be acceptable to the product owner.
28

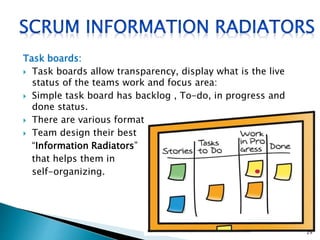

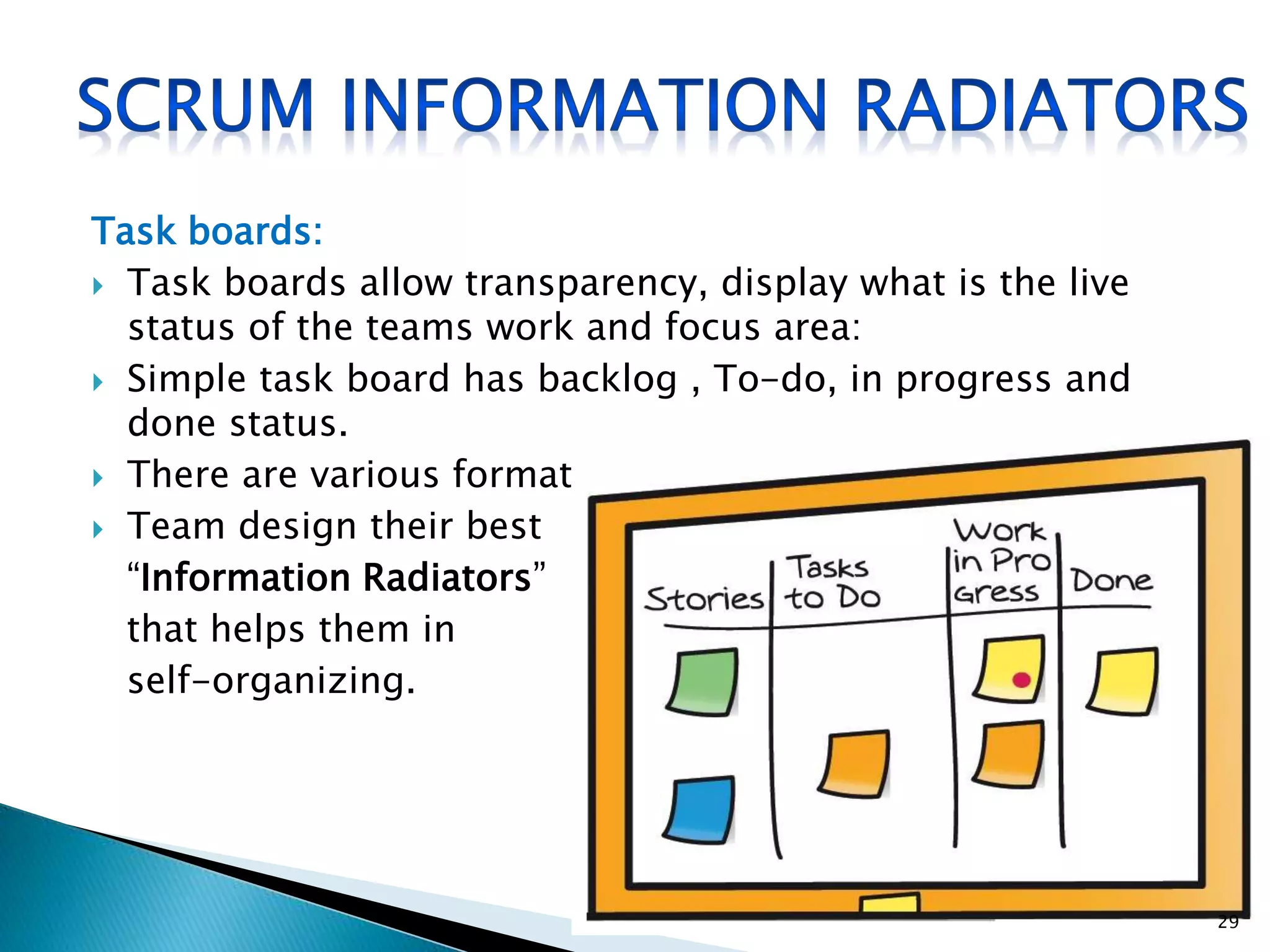

Task boards:
 Task boards allow transparency, display what is the live
status of the teams work and focus area:
 Simple task board has backlog , To-do, in progress and
done status.
 There are various format.
 Team design their best
“Information Radiators”
that helps them in
self-organizing.
29

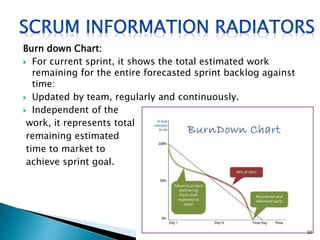

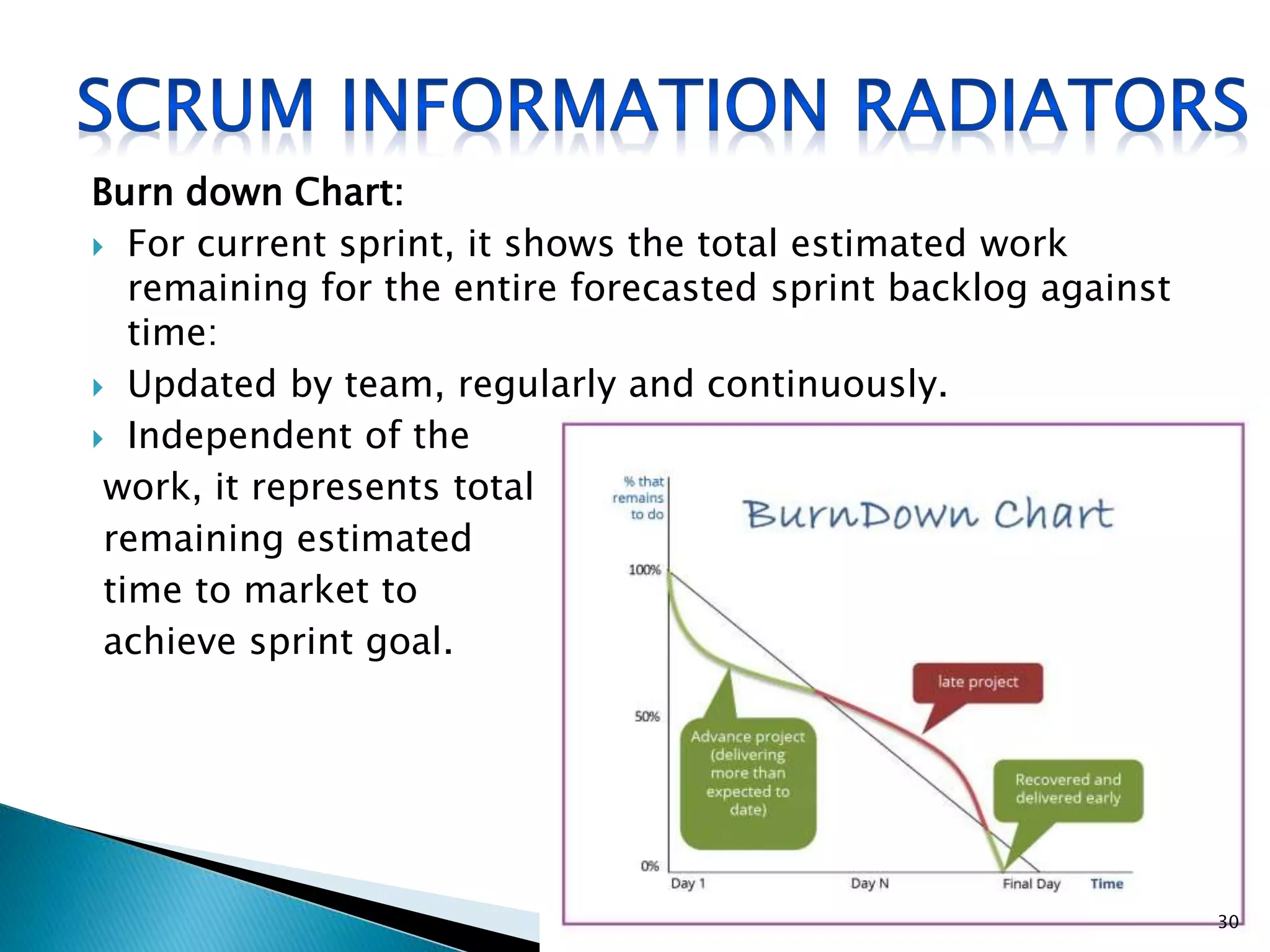

Burn down Chart:
 For current sprint, it shows the total estimated work
remaining for the entire forecasted sprint backlog against
time:
 Updated by team, regularly and continuously.
 Independent of the
work, it represents total
remaining estimated
time to market to
achieve sprint goal.
30

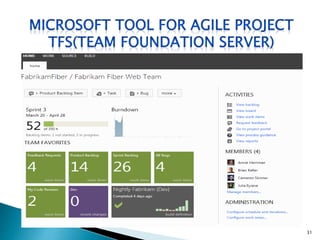

31
32
33
34
35
Kshitij Yelkar – PMP,CSM
www.yelkar.com
yelkar@gmail.com
9821588624
36

Agile Introduction - Scrum Framework

  • 1.
  • 2.
     What isAgile Methodology  What is Scrum Framework  Scrum Roles  Scrum Activities  Scrum Artifacts  Scrum Information Radiators  Microsoft Tool for Agile Project 2
  • 3.
    Agile methodology isan alternative to traditional project management, typically used in software development. It helps teams respond to unpredictability through incremental, iterative work, known as sprints. Agile methodologies are an alternative to waterfall, or traditional sequential development. There is agile manifesto and 12 principles 3
  • 4.
  • 5.
  • 6.
  • 7.
     Scrum isframework which is based on agile principles, a framework that handle simple, complicated and complex software development.  Scrum is based on continuous improvement in product and process.  Scrum deliver software frequently (value), it showcase the hidden problems in systems development.  In scrum project move forward with series of iteration that called Sprints.  Each sprint size is typically two to four weeks long. It is based on inspect and adaptive cycle.  Produce product incrementally and iteratively, thus reduce risk and enhance visibility. 7
  • 8.
  • 9.
     Product Owner Scrum Master  Team 9
  • 10.
    Product Owner  ProductOwner (PO) is client's representative.  Define features of product.  Decide release date and content.  Priorities features according to market value.  Be responsible for the profitability of product.  Accept or reject work items. 10
  • 11.
    Scrum Master  Coachfor scrum team.  Enacting scrum values.  Ensure team's productivity.  Build winning team.  Apply agile principles and make system effective. 11
  • 12.
    Team  5-9 Membersteam (Developer, Tester, BA).  Self-organizing, High performance team.  Build winning product.  Work collaboratively and share responsibilities.  Cross functional team. 12
  • 13.
     Sprint Planning Daily Scrum  Sprint Review  Sprint Retrospective  Product Backlog Refinement 13
  • 14.
    Sprint Planning : Goal: Team to plan and agree on backlog items they can complete and confirm the tasks required to support acceptance.  Who: Scrum Team, Scrum Master, Product owner.  When: Beginning of the Sprint.  Duration: 4 Hours for 2 weeks sprint.  How: In 2 parts.  Part 1: Define what needs to be done.  Part 2: How to achieve goal.  Input: Priority, Product Backlog, Acceptance criteria, Capacity.  Output: Sprint goal, Sprint Backlog, Tasks and their estimates, burn down chart, DOD.  Development plan/ Strategy. 14
  • 15.
    Description  Product ownerpresent the backlog items in priority order for review.  Review and clarify user Backlog items/stories.  Breakdown larger stories and each story into task and acceptance criteria.  Task are estimated in hours by team.  Developer and tester assigned to task.  Process continue until all available hours are used for the sprint.  Output of sprint planning is Sprint backlog, Estimated tasks, etc. 15
  • 16.
    Daily Scrum:  Goal:Plan for the day, Inspect and Adapt daily towards reaching the sprint goal.  Who: Scrum Team, Scrum Master.  When: Daily throughout the sprint.  Duration: 15 minutes maximum.  How: Team members form a group to focus on daily plan, Discuss on issues faced yesterday.  Input: Current status, risks, and done work.  Output: Plan for the day, task to work. 16
  • 17.
    Description:  Daily developmentTeam standup for 15 minutes in circle and talk only on three points. ◦ What I did since last daily scrum meeting? ◦ What I am planning to work on today? ◦ Impediments (Issue/blocker) if any?  Scrum master protect the team and facilitate for being effective.  This give an opportunity to team to inspect and adapt daily on the sprint goal. 17
  • 18.
    Sprint Review:  Goal:Get feedback on product development. Inspect and adapt on the product feature.  Who: Scrum Team, Scrum Master, Product owner, Stakeholders.  When: Last day of sprint.  Duration: 2 hours for a 2 week sprint.  How: Demonstrate the working product to all.  Input: Sprint goal, 100% done stories, acceptance criteria.  Output: Acceptance, feedback on demonstrated stories. 18
  • 19.
    Description:  During thismeeting team demonstrate 100% completed work.  Scrum master facilitate the environment.  In case any changes or new request, Product owner (PO) note and updates the product backlog as required.  Product owner is final decision maker on acceptance. 19
  • 20.
    Sprint Retrospective:  Goal:To inspect and adapt to become more effective and efficient on process, people, culture aspect.  Who: Scrum Team (anyone participation is decided by the scrum team on invite basis only).  When: Last day of sprint.  Duration: 2 hours for a 2 week sprint.  How: Close room discussion of observer pattern and desire results/improvements.  Input: Observation, issues, experience, pattern in behavior, recommendations, feedback and information.  Output: List of activities/steps/suggestions that help to make more effective and efficient. Action items on the team 20
  • 21.
    Description:  Participation inthe discussion to inspect and adapt as scrum team.  Scrum master play vital role in sprint retrospective, Scrum master bring in the culture of openness, trust and respect as people discuss the improvement areas, facilitate and focus on improvement and changes that pointing fingers at others.  This is platform to scrum master to help team resolve ineffectiveness in the systems.  Inspect and Adapt: Try everything that makes sense, reject things that didn’t work even after repeated trails. Shape your culture, process and practice. 21
  • 22.
    Product Backlog Refinement: Goal: Keep product backlog items ready, uncertainty to certainty.  Who: Scrum Team, Scrum master, product owner.  When: Continuous process, in between the sprints.  Duration: 1-3 hours depending on the team’s need.  How: priorities the items as per business value. Add, remove, modify existing product backlog item to achieve release scope/goal. Identify and discuss risks, dependencies and other uncertain items in acceptance criteria.  Input: release strategy, priority, product backlog, dependency/risk.  Output: product backlog items 100% ready for future sprint. 22
  • 23.
    Description:  Product ownerprovide clarity on each product backlog item (All uncertainty clarified into certainty).  Product owner update product backlog. 100% be present and involve all team members.  Team understand, carefully listen to need of product owner, understand the acceptance criteria.  Help product owner to order the backlog. 23
  • 24.
    The following arethe Artifacts in Scrum:  Product Backlog  Sprint Backlog  Product Increment 24
  • 25.
  • 26.
    Product Backlog: This isan ordered list of ideas for the product, which can come from the product owner, team members, or stakeholders. A description and estimate of effort complement each product backlog item. The product backlog is ordered to maximize the value delivered by the Scrum team. The development teams work comes from the product backlog, and nowhere else. Every feature, enhancement, bug fix, documentation requirement, every bit of work the team does comes from a product backlog item . The product backlog typically begins short and becomes longer and more defined as time goes on. Product backlog items soon will be "refined," which means they will further clarified, defined, and split into smaller chunks. Though the product owner is responsible for maintaining the product backlog, the development team helps produce and update it. 26
  • 27.
    Sprint Backlog: The sprintbacklog is the list of refined product backlog items chosen for development in the current sprint, together with the teams plan for accomplishing the work. It reflects the teams forecast of what work can be completed. Once the sprint backlog is established, the development team begins work on the new product increment. 27
  • 28.
    Product Increment  Everysprint produces a product increment, the most important Scrum artifact. A product Increment is the "goal line" for each sprint and, at the end of the sprint, it must:  Be of high enough quality to be given to users.  Meet the Scrum team's current definition of done.  Be acceptable to the product owner. 28
  • 29.
    Task boards:  Taskboards allow transparency, display what is the live status of the teams work and focus area:  Simple task board has backlog , To-do, in progress and done status.  There are various format.  Team design their best “Information Radiators” that helps them in self-organizing. 29
  • 30.
    Burn down Chart: For current sprint, it shows the total estimated work remaining for the entire forecasted sprint backlog against time:  Updated by team, regularly and continuously.  Independent of the work, it represents total remaining estimated time to market to achieve sprint goal. 30
  • 31.

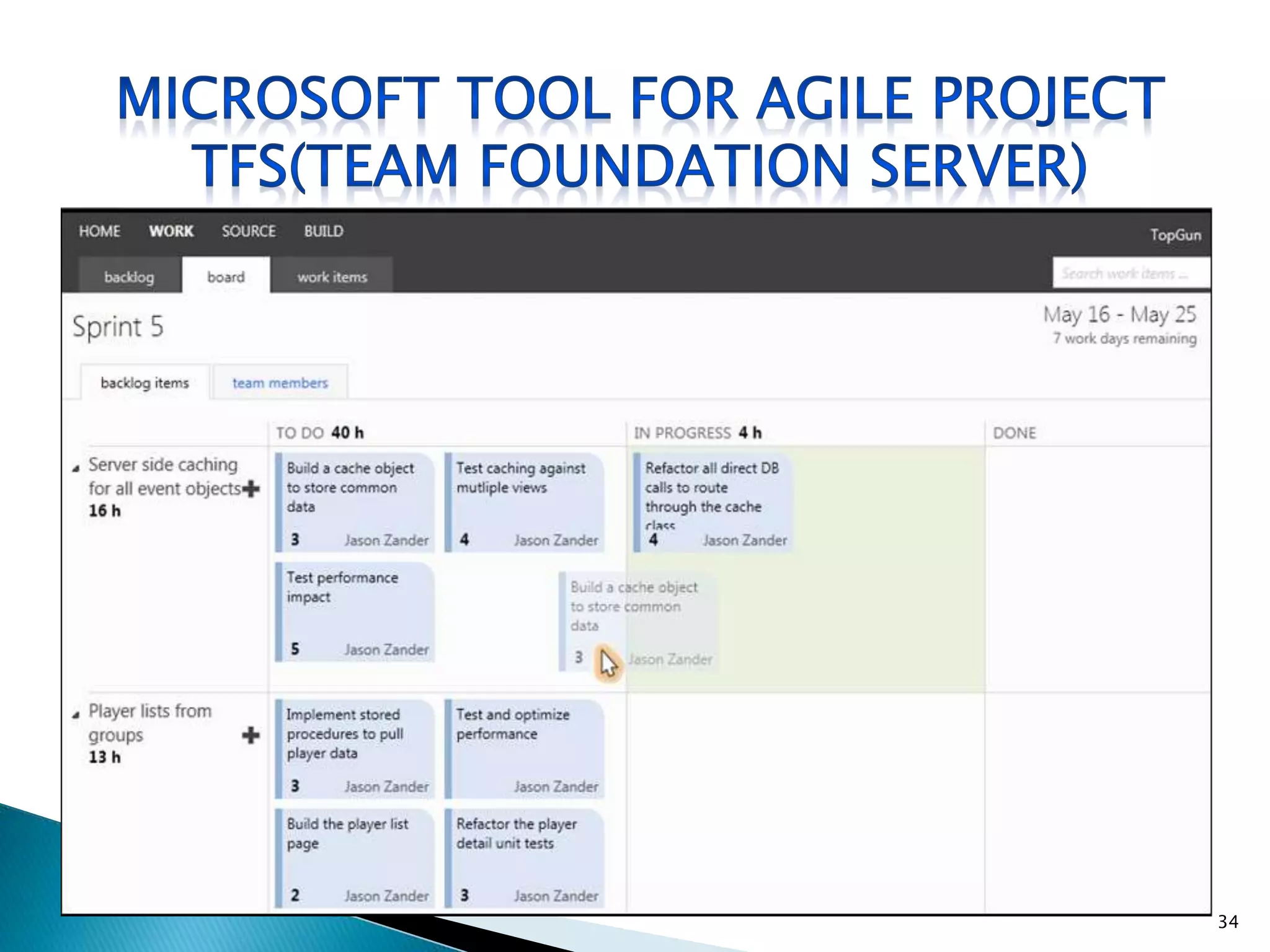

  • 32.
  • 33.
  • 34.
  • 35.
  • 36.
    Kshitij Yelkar –PMP,CSM www.yelkar.com yelkar@gmail.com 9821588624 36
